key takeaways
If you only read 30 seconds of this article:
- Critical spare parts management starts with classification by consequence of failure and lead time, not by cost or usage frequency.
- Stocking policy follows the classification: line-stop parts never reach zero, while low-consequence parts carry little or no standing stock.
- Governance is what keeps it aligned across sites, one policy, applied consistently, re-scored as assets and lead times change.
- Done at scale it protects uptime while freeing cash: a global offshore drilling operator scored 17 rigs by criticality and lead time, identified $151M, and enabled hub-and-spoke stocking, based on Verusen customer results.

Critical spare parts management
Short answer: Critical spare parts management is the discipline of identifying the parts whose failure most threatens production, setting a stocking policy for each by consequence of failure and lead time, and governing those policies consistently across every site. It replaces cost-based or usage-based stocking, which under-protects the intermittent parts that stop the line, with criticality-based stocking and enterprise governance that keeps the policy aligned as assets, failure rates, and lead times change.
Critical spare parts management: The classification, stocking, and governance of the spare parts whose failure would halt or degrade production, so the right parts are always available at the right site.
Step 1: classify by consequence, not cost
The foundation of critical spare parts management is classifying every part by what its failure does to production and how long it takes to replace, not by its price or how often it moves. A cheap gasket whose failure stops the line outranks an expensive motor that has a redundant backup. Classifying by cost or usage, the common default, systematically under-protects the intermittent, high-consequence parts that matter most. This is the criticality step detailed in the companion MRO criticality analysis guide, and it depends on AI-powered MRO inventory optimization to run at enterprise scale.
Once parts are ranked by consequence and lead time, the stocking policy writes itself.
| Class | Profile | Stocking policy |
|---|---|---|
| Critical | Failure stops the line | Always on hand; never reach zero |
| Essential | Degrades output or long lead time | Failure rate + lead time + margin |
| Standard | Workaround exists | Demand minimum or reorder point |
| Non-critical | No production impact | No standing stock; order on demand |

Critical spare parts classification
Step 2: set stocking policy by criticality

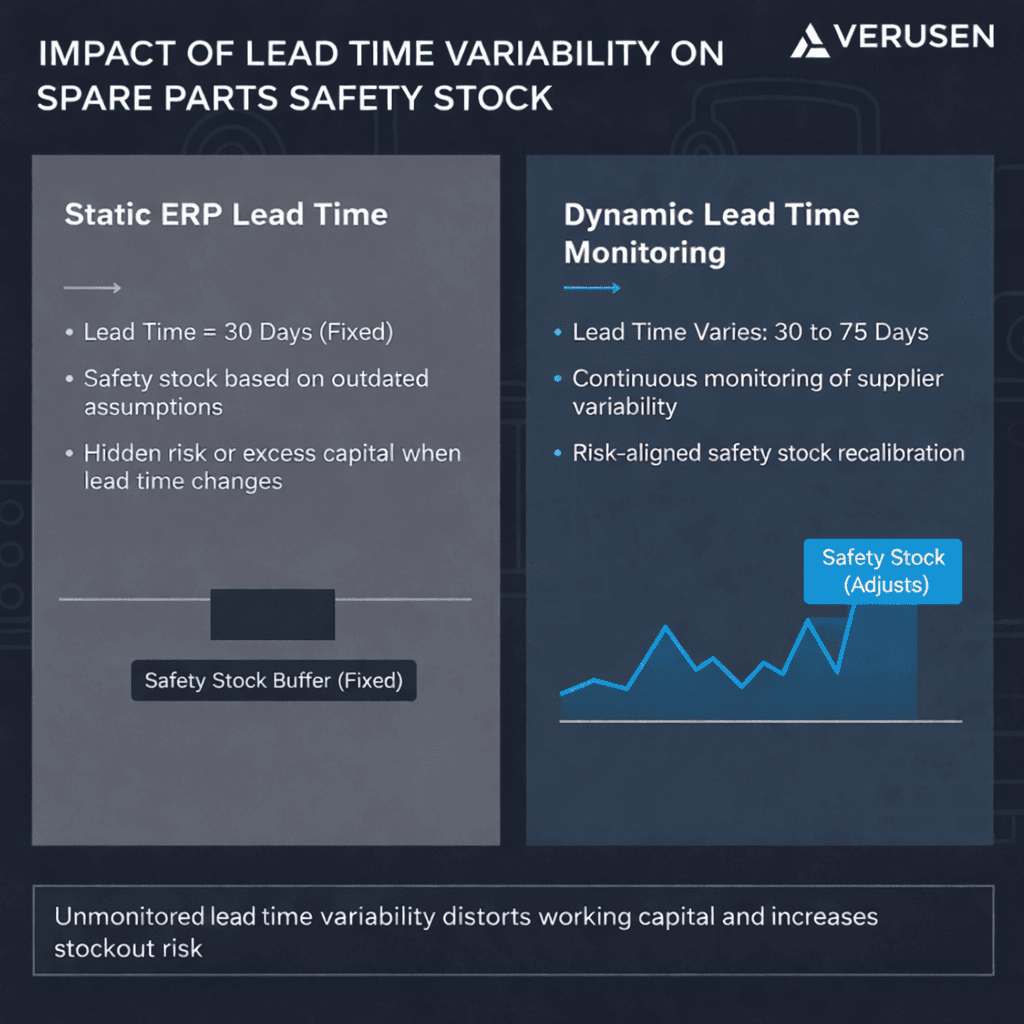

Stocking policy for critical spares is sized by failure rate and lead time, not demand history, because the parts that matter fail too rarely to leave a demand signal. A critical part that fails twice in five years still needs a standing buffer, because the cost of not having it dwarfs the carrying cost. Since a single missing critical spare can cost as much as $260,000 per hour of downtime (Aberdeen Strategy & Research), the buffer pays for itself the first time it is used. The mechanics are covered in the safety stock formula reference and this spare parts inventory management guide.
Step 3: govern it across sites
Classification and policy only hold if they are governed. Without governance, each site drifts, re-classifying parts locally, hoarding buffers, and letting policies go stale as assets and suppliers change. Enterprise governance means one criticality model applied consistently across every site, ownership of the policy, and periodic re-scoring so it reflects current failure rates and lead times. This is where most programs quietly fail, and where an AI platform that re-scores continuously replaces the spreadsheet that goes stale.
A global offshore drilling operator shows the payoff of disciplined classification and governance across a fleet: scoring parts by criticality and lead time across 17 rigs on Maximo, it identified $151M in MRO inventory and enabled a hub-and-spoke shorebase-to-rig stocking model, based on Verusen customer results.
| critical parts at stockout risk (industry estimate) | 10-15% |
| all-in downtime cost per hour (Aberdeen) | $260K |
| A global offshore drilling operator: identified across 17 rigs, criticality-scored | $151M |

Critical spare parts results
How to run critical spare parts management at scale
Turn the three steps into a repeatable, governed program.
- Classify every part by consequence of failure and lead time, consistently across sites.
- Set stocking policy per class; lock critical and essential parts first.
- Assign ownership and re-score on a cycle so the policy never goes stale.
- Automate classification and re-scoring; hand-scoring hundreds of thousands of parts does not scale.
- Keep engineers in the loop to validate high-impact classifications.
Most customers reach a working solution in under 60 days, with no data cleanse required first, based on Verusen customer results. Then talk to an MRO expert to classify your own critical spares.
Further reading: spare parts inventory management guide, spare parts classification (ABC/XYZ), and safety stock formula methods.
Frequently asked questions
It is the discipline of identifying the parts whose failure most threatens production, setting a stocking policy for each by consequence of failure and lead time, and governing those policies consistently across every site. It replaces cost- or usage-based stocking, which under-protects intermittent line-stop parts.
By consequence of failure and replacement lead time, not by price or usage frequency. A cheap part whose failure stops the line outranks an expensive one with a redundant backup. The classification then drives a stocking policy per class, from always-on-hand for critical parts to no standing stock for non-critical ones.
Enough that it never reaches zero, sized by failure rate and lead time rather than demand history. A critical part that fails twice in five years still needs a buffer, because a single missing critical spare can cost as much as $260,000 per hour of downtime (Aberdeen Strategy & Research).
Because without it each site drifts, re-classifying parts locally, hoarding buffers, and letting policies go stale. Governance means one criticality model applied consistently, clear ownership, and periodic re-scoring so the policy reflects current failure rates and lead times.
Yes, but only with automation. Hand-scoring hundreds of thousands of parts and keeping them current is not feasible. A global offshore drilling operator scored 17 rigs by criticality and lead time, identified $151M, and enabled hub-and-spoke stocking, based on Verusen customer results.
